Accessibility Remodeling and Permits in Sacramento

Accessibility planning · Sacramento

Accessibility Remodeling and Permits in Sacramento

Accessibility is a connected route. The property type, user, approach, doors, clearances, fixtures, controls and permit path must work together before construction begins.

Open residential shower used as an accessibility planning reference
Planning reference image. A private residential accessibility remodel should be designed for the user and property. It should not be described as ADA compliant solely because it includes a low entry, handheld shower or support features.

First decision

Which accessibility framework applies to the property?

The answer changes with the building and scope. “ADA” is not a catchall term for every residential, multifamily, commercial or public project.

01 · Private home

Design for the resident.

An exclusively private residence is generally not a Title III public accommodation. The plan can use accessibility references while following the requirements that actually apply to the home and scope.

02 · Multifamily housing

Confirm 11A or 11B scope.

California housing accessibility provisions require project-specific review. Covered multifamily housing and public housing do not use one interchangeable rule set.

03 · Commercial space

Federal and California rules can overlap.

Restaurants, stores, offices and other public accommodations may involve ADA Title III, California Chapter 11B and path-of-travel obligations.

04 · Public facility

Title II and Chapter 11B matter.

State and local government facilities require the applicable public-facility accessibility analysis and permit documentation.

The accessibility chain

Can a person reach, enter, move, turn and use the space?

A compliant-looking fixture cannot repair a broken route. Review the sequence from arrival through every space and control the person needs.

01

Approach

Parking or site arrival, walkway, slope, surface and obstacles.

02

Gate

Clear opening, approach, transition, latch height and one-hand operation.

03

Entrance

Landing, threshold, door swing, hardware, closer and weather protection.

04

Interior route

Continuous clear path, turns, floor transitions and passing conditions.

05

Use area

Dining, service, work or living surfaces with usable approach and reach.

06

Restroom

Door maneuvering, turning, lavatory, mirror, toilet and accessory relationships.

07

Bathing

Entry, seat, controls, support, drainage, waterproofing and caregiver space.

08

Exit

The return route must remain usable without furniture, storage or door conflicts.

The eight links of an accessible routeApproach, gate, entrance, interior route, use area, restroom, bathing and exit shown as one connected sequence.01Approach02Gate03Entrance04Interiorroute05Usearea06Restroom07Bathing08ExitA break at any single link ends the route. The last four cannot compensate for the first four.The eight links of an accessible routeApproach, gate, entrance, interior route, use area, restroom, bathing and exit shown as one connected sequence.01Approach02Gate03Entrance04Interior route05Use area06Restroom07Bathing08ExitA break at any single link ends the route.The last four cannot compensate for the first four.
The eight links in sequence. A compliant fixture at link 07 is unreachable if link 01 or 03 fails.

Send the route, not just the room.

Photographs of the approach, the doorway and the room together tell us more than a single fixture ever will. We will identify the measurement and permit decisions that come next.

Federal reference dimensions

What do common ADA dimensions mean in context?

These are selected federal reference points for covered facilities. They do not certify a project and do not replace California requirements, project drawings or professional review.

36 in

Accessible walking surface

General federal minimum clear width. Limited short constrictions may use different conditions under the standard.

32 in

Door clear opening

General federal minimum measured with a swinging door open 90 degrees. Maneuvering space and hardware still matter.

60 in

Turning circle

Federal circular turning-space reference. A compliant T-shaped option may be used where its detailed conditions are met.

15–48 in

Unobstructed reach

Common federal adult reach range. Obstructions, approach direction and the operable part change the analysis.

34 in max

Lavatory rim or counter

Federal reference for an accessible lavatory with the required forward approach, knee and toe clearances.

17–19 in

Water-closet seat

Federal seat-height reference. Centerline, clearance, grab bars, accessories and transfer approach must also coordinate.

Never use an isolated number as a complete design. Confirm what is being measured, the governing framework, the approach direction, overlaps, door swings, fixture clearances and the approved project documents.

Sacramento permit path

When does accessibility work affect plan review?

Sacramento uses the 2025 California Building Standards Code for applications under the code cycle effective January 1, 2026. The permit route depends on the address and final scope.

Project conditionLikely planning questionWhat to document
Nonstructural residential bathroomMay fit the City minor-permit process when no structural alteration or floor-plan change is proposed.Existing plan, fixture scope, plumbing and electrical work, ventilation and product locations.
Wall, window or door changesStructural alteration or changed openings can require plan review.Existing and proposed plans, framing, header, dimensions and related systems.
Commercial remodelCommercial projects use electronic plan check and existing commercial remodels require the applicable Planning approval before Building Plan Review.Code analysis, accessible route, path of travel, plans, details and project-specific accessibility notes.
Work ready to coverRequired inspections must occur before permitted work is concealed.Approved plans onsite, inspection result, photographs and corrections before closure.

Review timeline

How long does Sacramento plan review take?

These are the City's own published cycle times in working days. A non-structural residential bathroom or kitchen remodel is a minor permit and has no plan review cycle at all: no construction plans are required and code compliance is performed in the field.

Project typeFirst reviewSecond reviewThird review
Residential interior alteration12 days8 days5 days
Residential addition15 days10 days5 days
Accessory structure, repair or garage conversion10 days5 days5 days
Commercial alteration valued up to $400,00015 days10 days10 days
Commercial alteration above $400,000 and under $3 million20 days15 days15 days

The City guarantees these cycles only for complete submittals, and the Chief Building Official or a supervising engineer may adjust them. Expedited cycle times can be requested. Plan the calendar around the number of review rounds rather than the first one: an incomplete drawing set is what turns 12 working days into a month. Source: City of Sacramento form CDD-0294, revised March 4, 2026.

Permit cost

What does the permit itself add to the budget?

Sacramento does not charge one flat remodel permit fee. A non-floor-plan-altering bathroom remodel permit carries the charges below, and any scope covering more than a single fixture or circuit is calculated from declared project valuation instead of a flat amount.

Always charged

A building permit fee, general plan fee, green building fee and technology fee are due on every non-floor-plan-altering bathroom remodel permit.

Sometimes charged

City operations tax applies only when a California licensed contractor is the permit holder rather than the owner.

Driven by valuation

Once the scope passes a single fixture or circuit the permit fee follows declared project value, so the fixture and finish budget moves the permit fee with it.

For a figure you can put in a budget, the City prepares a written preliminary fee estimate: submit its fee estimate worksheet with a valid street address or parcel number, pay a processing fee billed at the current staff hourly rate, one hour for valuations under $1 million, and allow about ten business days. No dollar range is published on this page because the amount is set by your declared valuation and your address, and a generic range would not survive the counter.

Get the permit path confirmed before you design around it.

The review cycle and the fee both follow the final scope. Send the address and what you want to change, and the reply will name the likely permit route and the documents it needs.

Design and construction evidence

Which decisions disappear behind finishes?

The images below illustrate planning conditions to discuss with your designer.

Resident using an easy-to-grasp handle beside a bathroom support rail
User path. Review handles, reach, balance, approach and the sequence of daily movement.
Hand using a securely mounted bathroom support bar
Support location. A bar must fit the user, transfer method, wall construction and approved fastening system.
Bathroom renovation before walls and finishes conceal rough work
Before concealment. Framing, reinforcement, plumbing, electrical and wet-area work should be coordinated and inspected at the required hold points.

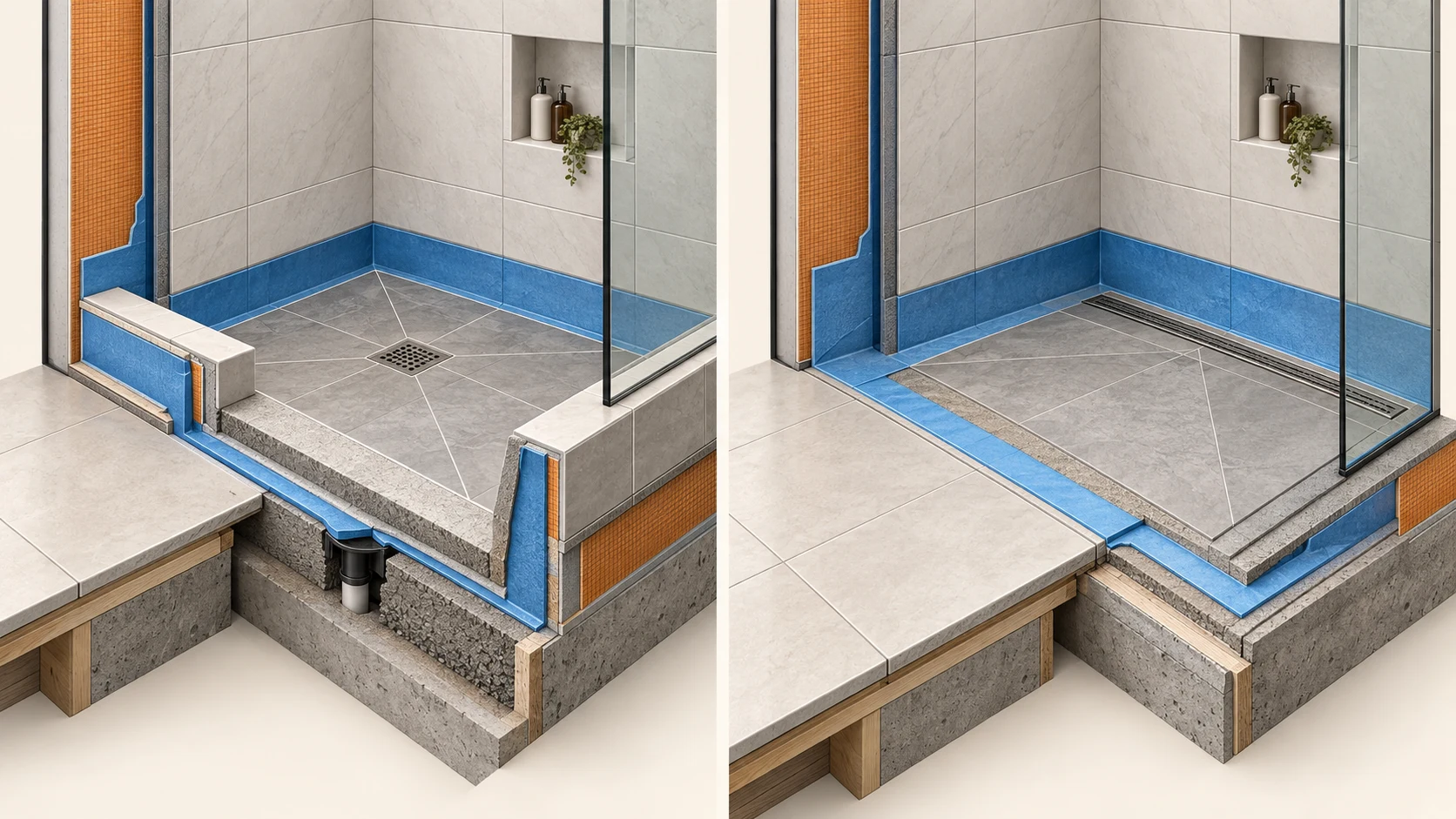

Cutaway comparison of a curbed shower receptor beside a curbless receptor, showing substrate, waterproofing and drain positions
Where the accessibility decision actually happens. A curbless entry is set by the framing, recess, substrate slope, waterproofing and drain position, all of which are fixed before tile. Choosing it after rough inspection means reopening the floor.

Proposal checklist

What should an accessibility remodeling proposal identify?

The written scope should connect the user, applicable rules, permit documents and construction responsibility.

User and route

Property type, resident or public use, mobility device, helper needs, approach, doors, turning, reach and required spaces.

Plans and review

Existing and proposed drawings, governing framework, permit path, CASp or design-professional involvement when appropriate, and inspection points.

Construction record

Products, framing and backing, rough locations, transitions, substitutions, concealed-condition photographs, approvals and closeout documents.

Official sources

Use current records for the property and scope.

REVIEWED SEPTEMBER 2026
Codes, valuation thresholds, forms and local review procedures can change. Confirm the current documents before filing.

  1. 01ADA Title III regulations
  2. 02U.S. Access Board Chapter 4
  3. 03U.S. Access Board Chapter 6
  4. 04City of Sacramento building codes
  5. 05City minor permits
  6. 06Sacramento electronic plan check
  7. 07Sacramento building inspections
  8. 08California CASp property inspection

Written by Emin, Chief Designer, using official federal, California and City of Sacramento sources. A qualified CASp or design professional can be brought in when the project needs that review.

Residential planning tool

Organize the bathroom scope before pricing.

Use the Bathroom Remodel Budget Estimator to record layout, wet-area and finish assumptions. Accessibility dimensions and permit requirements still Accessibility work is often not bathroom led. For adjacent scope see the accessible kitchen guide or the bathroom remodeling service, and the Sacramento service area for coverage.

Accessibility permit FAQ

Questions to resolve before design and construction

Does a private home have to be ADA compliant?

An exclusively private residence is generally not a Title III public accommodation. The project should be designed for the resident and evaluated under the requirements that actually apply to the property and scope.

Is a 36-inch door automatically accessible?

No. The clear opening, approach, maneuvering space, hardware, threshold, closer and connected route all matter. Nominal door size alone does not establish accessibility.

Does adding grab bars make a bathroom accessible?

No. Support location, backing, approach, transfer space, toilet or shower relationships, controls, reach, lighting and the route into the room must work together.

When does a Sacramento residential bathroom need plan review?

The City minor-permit path applies to qualifying nonstructural work. Structural alterations, wall or opening changes, layout changes and other scope can require plan review. Confirm the address and final scope with the City.

Do commercial remodels have different accessibility requirements?

Yes. A restaurant, store, office or other public accommodation may involve federal ADA Title III, California Chapter 11B, path-of-travel obligations and Sacramento commercial review.

Should a commercial owner hire a CASp?

A CASp provides specialized California accessibility review. Whether to engage one depends on the property, project and owner's risk and documentation needs.

What should I send for an accessibility project review?

Send the property address, building type, photographs, approximate dimensions, current obstacles, intended users, mobility devices, helper needs, desired rooms or routes and any existing plans or permit records.

How long does accessibility remodeling plan review take in Sacramento?

The City publishes cycle times in working days. A residential interior alteration is 12 days for first review, 8 for a second and 5 for a third. A commercial alteration valued up to $400,000 is 15, 10 and 10. A non-structural residential bathroom or kitchen remodel is a minor permit with no plan review cycle at all, because no construction plans are required and compliance is checked in the field. The published cycles apply only to complete submittals.

How much do permits and inspections add to the budget?

A non-floor-plan-altering residential bathroom remodel permit carries a building permit fee, a general plan fee, a green building fee and a technology fee, plus city operations tax when a California licensed contractor is the permit holder. Any scope beyond a single fixture or circuit is calculated from declared project valuation rather than a flat amount, so there is no fixed figure. The City will prepare a written preliminary fee estimate from its worksheet and a valid street address or parcel number, for a processing fee, in about ten business days.

Map the complete route before changing one fixture.

Send the property type, address, photographs, approximate dimensions and the access problem you want to solve. The review will identify the next measurement, permit and design decisions.
